Success Stories

COMPLETED PROJECTS · 2021 — 2026

Success
Stories.

Borefields, tailings, headworks and bulk water infrastructure delivered across some of Australia’s most demanding sites. A record of work executed in full — safely, on schedule, to specification.

$209M+
COMBINED PROJECT VALUE
450km+
HDPE PIPE WELDED & LAID
7
MAJOR CASE STUDIES
NT & WA
OPERATING ACROSS

7 of 7 case studies

Case 01 · P23086

Arafura Nolans Project

Borefields Headworks Infrastructure

Completed

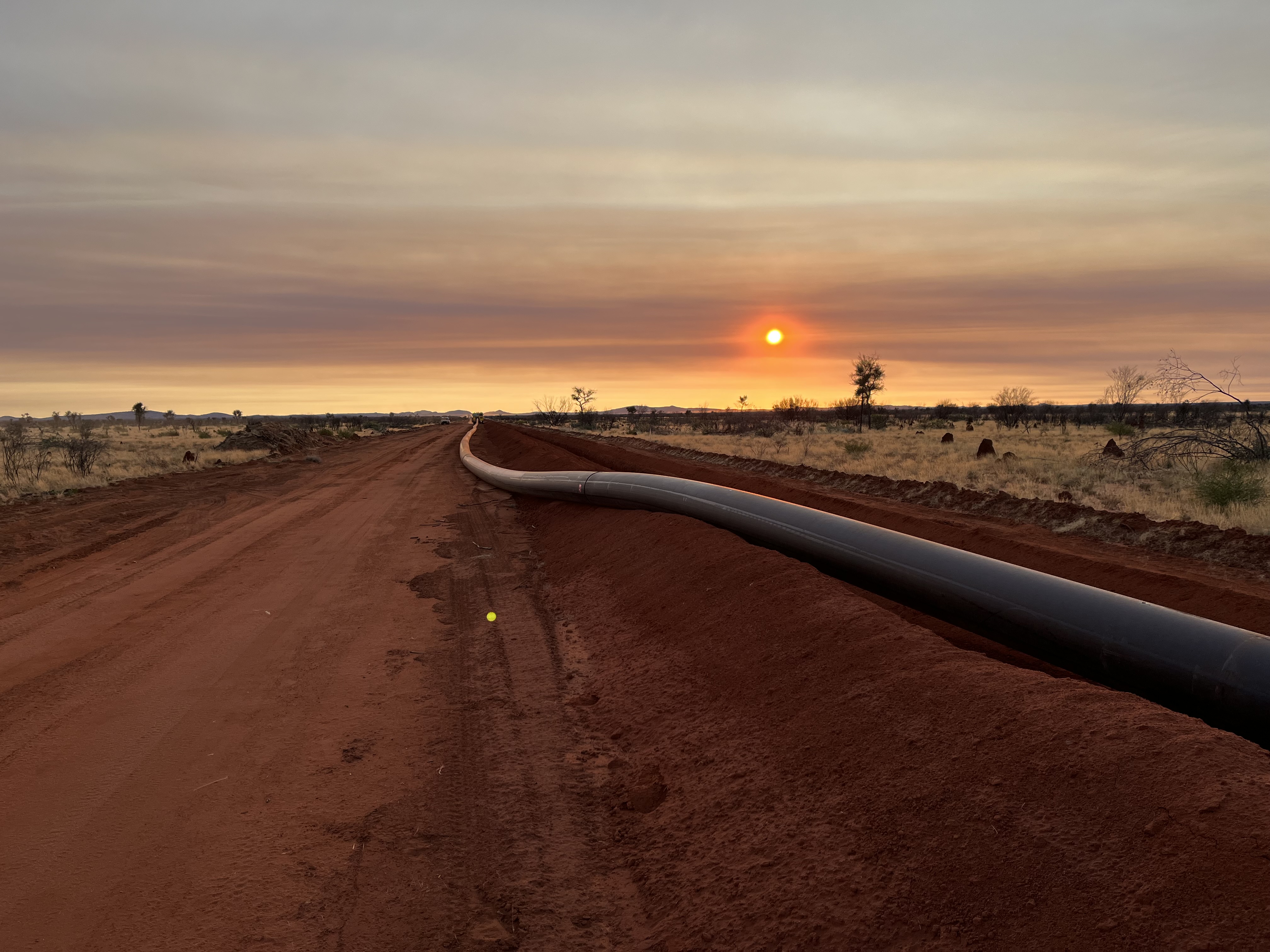

DN450 HDPE pipeline, Nolans Borefields
DN450 HDPE pipeline

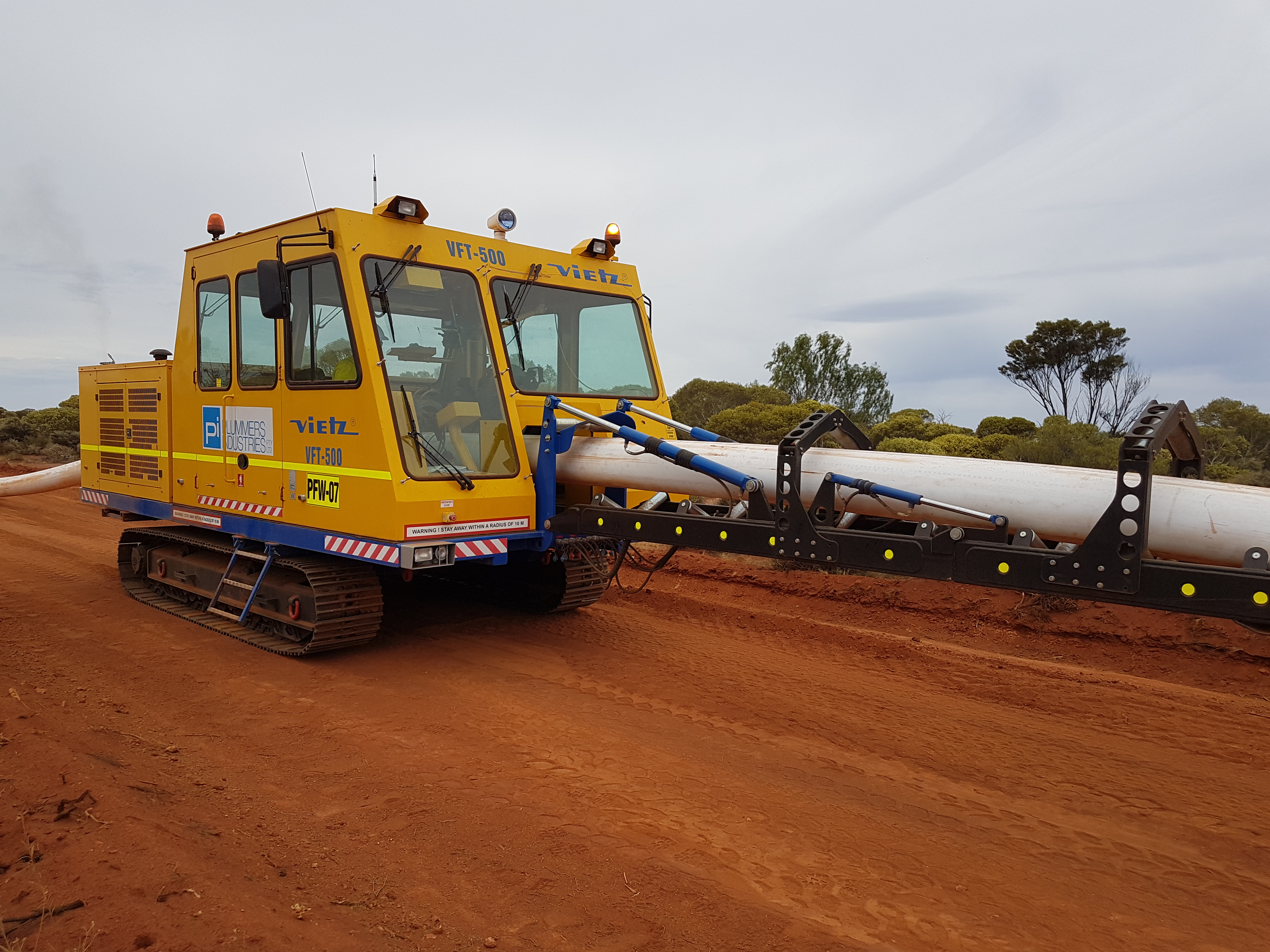

Vietz VFT-500
VIETZ VFT-500

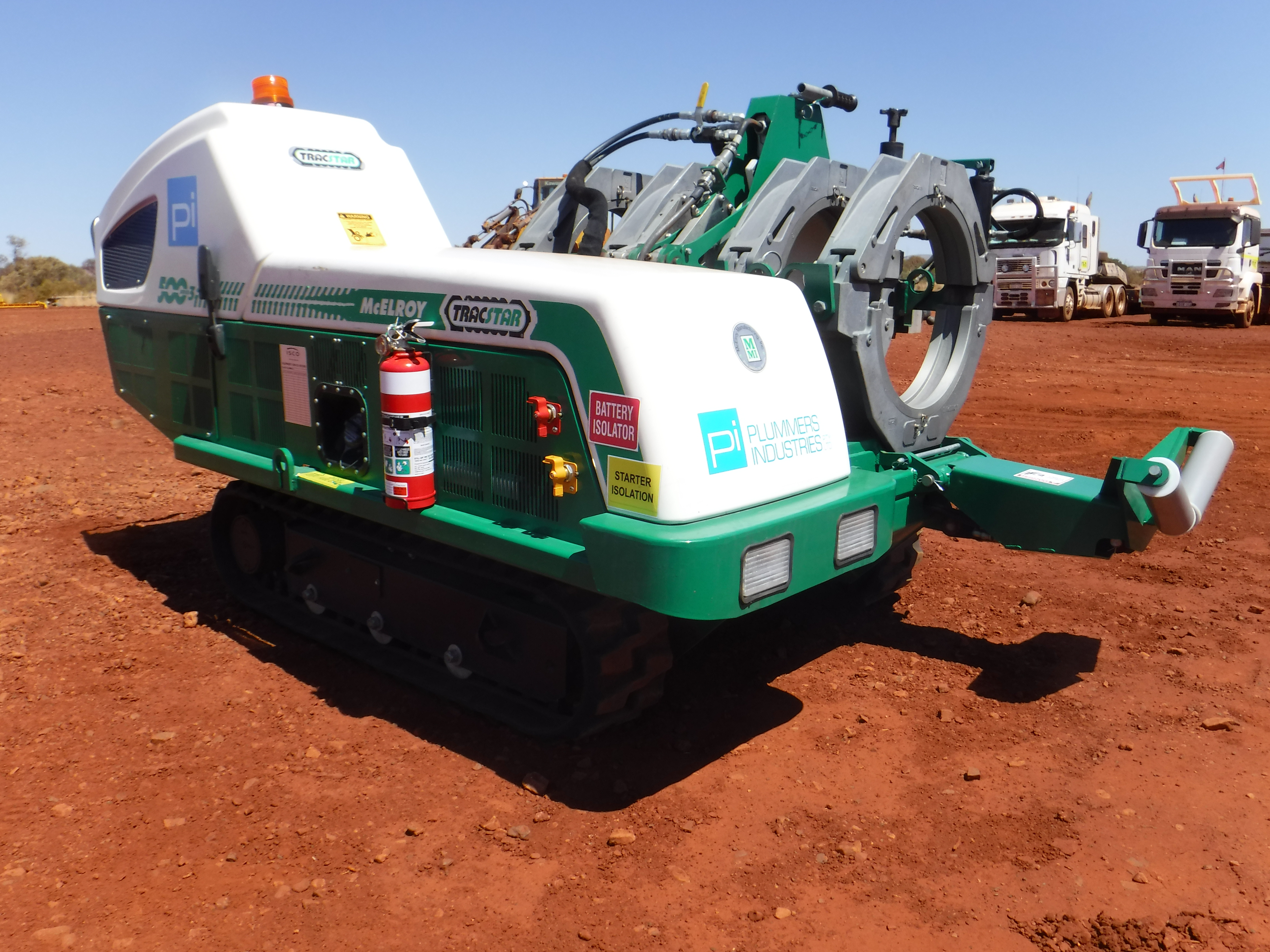

McElroy T500
MCELROY T500

Scope of Work

The scope encompassed the design and delivery of a complete borefield and water transfer system, including the installation of borefield headworks infrastructure, two extraction bores, and a 300 m³ storage tank. Works also included approximately 24.5 km of buried DN450 HDPE pipeline, plus the supply and installation of all associated headworks, valves, transfer pumps, piping, control panels, instrumentation, and ancillary equipment required for full system operation.

Project Highlights

  • 24 km of DN450 HDPE pipe fully buried
  • 20,000 manhours · LTI free
  • Remote site, 130 km north of Alice Springs
  • Early works delivered with no existing infrastructure

Client
Project
Location
Date
Value

Arafura Nolans
Nolans Borefields
130 km north of Alice Springs, NT
May 2023 — September 2023
$7M

Equipment Engaged +

Earthworks

  • 35t Excavators
  • Cat 966 Loader
  • Wheel Loaders
  • Skid Steers
  • Telehandler
  • 12M Grader
  • 40t Articulated Dump Trucks (Moxys)

Welding

  • Vietz VFT-500 Butt Welder
  • Dixon HF225 Butt Welders
  • Dixon HF355 Butt Welders
  • McElroy T500 Poly Welders
  • McElroy T900 Poly Welders

Site Fleet

  • 6×4 Water Trucks
  • 6×4 Tipper Truck
  • 6×4 Service Truck
  • Light Vehicles

Power

  • 6 kVa Gensets
  • 12 kVa Gensets
  • 35 kVa Gensets
Safety Performance +
AIFR
All Injury Frequency
1.00
LTIFR
Lost Time Injury Freq.
0.00
MTIFR
Medical Treatment Freq.
0.00
RWIFR
Restricted Work Freq.
0.00
TRIFR
Total Recordable Freq.
0.00

Case 02 · P23152

Western Range

New Process Infrastructure (NPI)

Completed

civil engineering projects

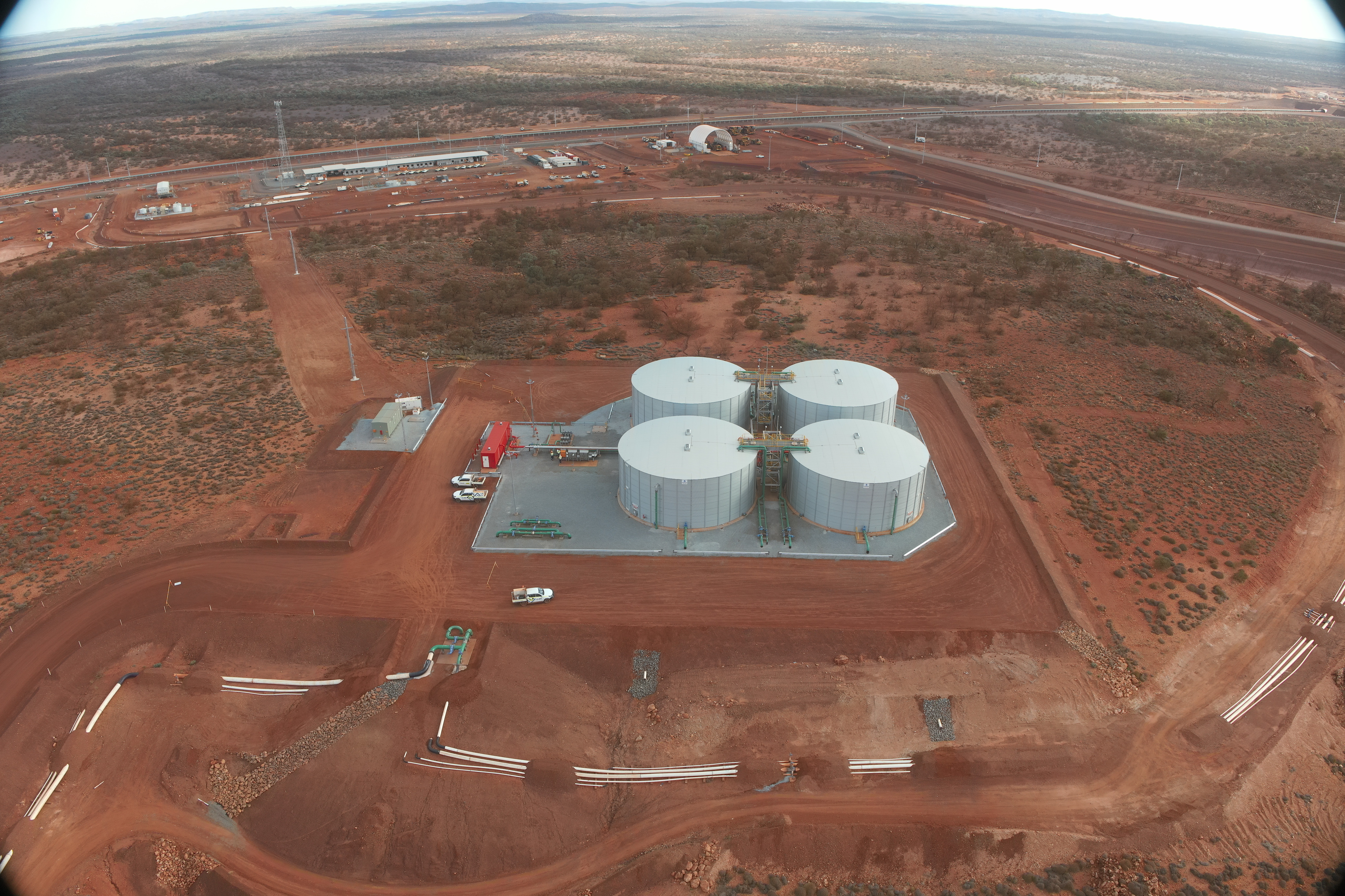

NPI Hub
civil engineering projects

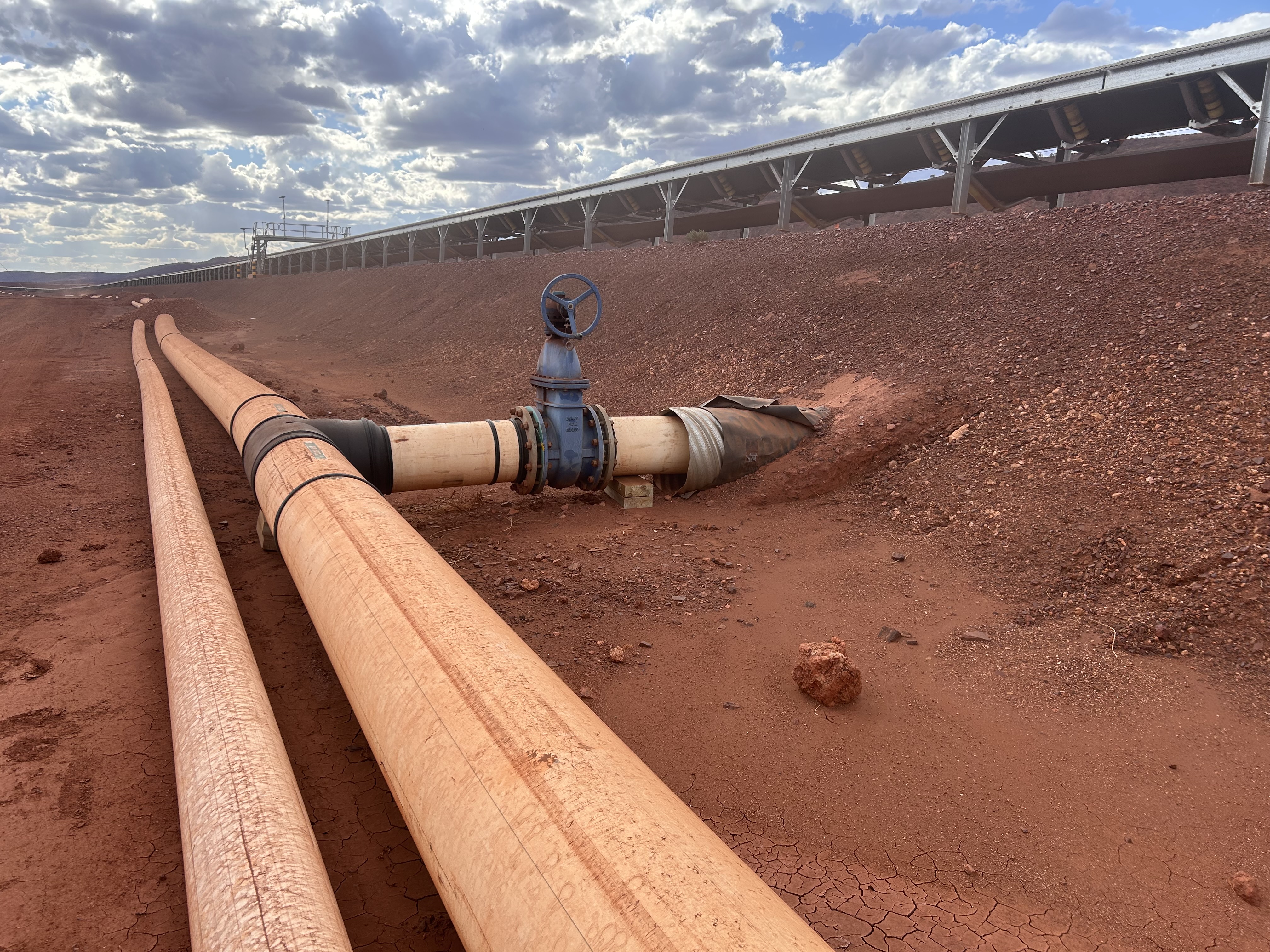

Service water main

// ABSTRACTION BORE TIE-IN

Abstraction bore tie-in

Scope of Work

Delivered the bulk New Process Infrastructure (NPI) package for Western Range — every water service the mine would run on at start-up, plus the storage and abstraction that feeds them, plus the electrical and comms backbone tying it together. Fire, raw, service and potable water main from ND32 through to DN560; four 3,000 kL raw & fire tanks complete with pumps and stainless pipework; abstraction bores dropped in and tied off; and the NPI Hub electrical and communication conduits laid in.

Project Highlights

  • 700 days / 300,000 manhours LTI/MTI free
  • Awarded Worley Contractor of the Month — November 2024
  • Crews worked in parallel across pipelines, tanks and bores
  • Client-initiated scopes executed without schedule slip

Client
Project
Location
Date
Value

Worley Energy
Western Range NPI
Pilbara, WA
August 2023 — March 2025
$96M

Equipment Engaged +

Earthworks

  • 35t Excavators
  • Cat 966 Loader
  • Wheel Loaders
  • Skid Steers
  • Telehandler
  • 12M Grader
  • 40t Articulated Dump Trucks (Moxys)

Welding

  • Vietz VFT-500 Butt Welder
  • Dixon HF225 / HF355 Butt Welders
  • McElroy T500 / T900 Poly Welders

Site Fleet

  • 6×4 Water Trucks
  • 6×4 Tipper Truck
  • 6×4 Service Truck
  • Light Vehicles

Power

  • 6 kVa Gensets
  • 12 kVa Gensets
  • 35 kVa Gensets
Safety Performance +
AIFR
All Injury Frequency
5.00
LTIFR
Lost Time Injury Freq.
0.00
MTIFR
Medical Treatment Freq.
0.00
RWIFR
Restricted Work Freq.
0.00
TRIFR
Total Recordable Freq.
0.00

Case 03 · P23129

Mt Keith Village

Borefield Upgrade

Completed

// HERO IMAGE
Borefield headworks · Mt Keith

Borefield headworks

// EXTRACTION BORE INSTALL

Extraction bore install

// ROCK BREAKING

Rock breaking

Scope of Work

Installed borefield headworks infrastructure including 4.5 km of HDPE pipe and three new extraction bores, with replacement of four existing extraction bore pumps. Supply and installation of all associated headworks, valves, transfer pumps, piping, control panels, instrumentation, and ancillary equipment to bring the upgraded village water supply online.

Project Highlights

  • 7,708 manhours with zero recorded injuries
  • 4 km of extensive rock breaking and excavation
  • Delivered with limited IFC drawings at commencement
  • Three new bores commissioned plus four existing pumps replaced

Client
Project
Location
Date
Value

BHP Nickel West
Village Borefield Upgrade
Mt Keith Village, WA
July 2023 — October 2023
$2.1M

Equipment Engaged +

Earthworks

  • 22t & 33t Excavators
  • 36t Excavator with Rock Breaker
  • Wheeled IT Loaders
  • Skid Steers

Welding

  • Dixon HF225 Butt Welders

Site Fleet

  • 6×4 Water Trucks
  • 6×4 Tippers
  • Franna Crane
  • Light Vehicles

Power

  • 6 kVa Gensets
  • 12 kVa Gensets
Safety Performance +
AIFR
All Injury Frequency
0.00
LTIFR
Lost Time Injury Freq.
0.00
MTIFR
Medical Treatment Freq.
0.00
RWIFR
Restricted Work Freq.
0.00
TRIFR
Total Recordable Freq.
0.00

Case 04 · P24021

FMG Cloudbreak

MSA Minor Projects · Bulk Water Transfer

In progress

// HERO IMAGE
300 km HDPE bulk water transfer

300 km HDPE bulk water transfer

// MAINLINE WELDING

Mainline welding

// 2,100 HA LAND CLEARING

2,100 ha land clearing

Scope of Work

Multi-year MSA delivering water abstraction infrastructure and bulk water transfer for FMG Cloudbreak. Scope spans approximately 300 km of HDPE bulk transfer pipeline (DN250–DN630), water injection bore fields, 2,100 ha of land clearing with 440,000 m³ of topsoil removed, and all corresponding headworks, valves, pumps, generators, control panels, instrumentation, telemetry, HDPE lining, standpipes, fencing and ancillary equipment. Pipe range DN315 — DN630, PN6.3 — PN16.

Project Highlights

  • 111,000 m of mainline pipe welded
  • 9,300 total welds completed
  • 700 days LTI free across the campaign
  • 300 km HDPE bulk water transfer pipeline

Client
Project
Location
Date
Value

Fortescue Metals Group
FMG MSA Minor Projects
Cloudbreak, WA
February 2021 — current
$80M

Equipment Engaged +

Earthworks

  • 35t Excavators
  • D8 Bulldozer
  • Cat 966 Loader
  • Wheel Loaders
  • Skid Steers
  • 12M Grader
  • 40t Articulated Dump Trucks (Moxys)

Welding

  • Vietz VFT-900 Butt Welder
  • Dixon HF355 / HF630 Butt Welders
  • McElroy T630 / T900 Poly Welders

Site Fleet

  • 6×4 Water Trucks
  • 6×4 Tipper Truck
  • 6×4 Service Truck
  • Franna Crane
  • Light Vehicles

Power

  • 6 kVa Gensets
  • 12 kVa Gensets
  • 35 kVa Gensets
Safety Performance +
AIFR
All Injury Frequency
19.00
LTIFR
Lost Time Injury Freq.
0.00
MTIFR
Medical Treatment Freq.
1.00
RWIFR
Restricted Work Freq.
0.00
TRIFR
Total Recordable Freq.
0.00

Case 05 · P23313

Jugari MAR

Managed Aquifer Recharge Pipeline

Completed

civil engineering projects
MAR raw water pipeline
// RAIL CORRIDOR WELDING

Rail corridor welding

civil engineering projects

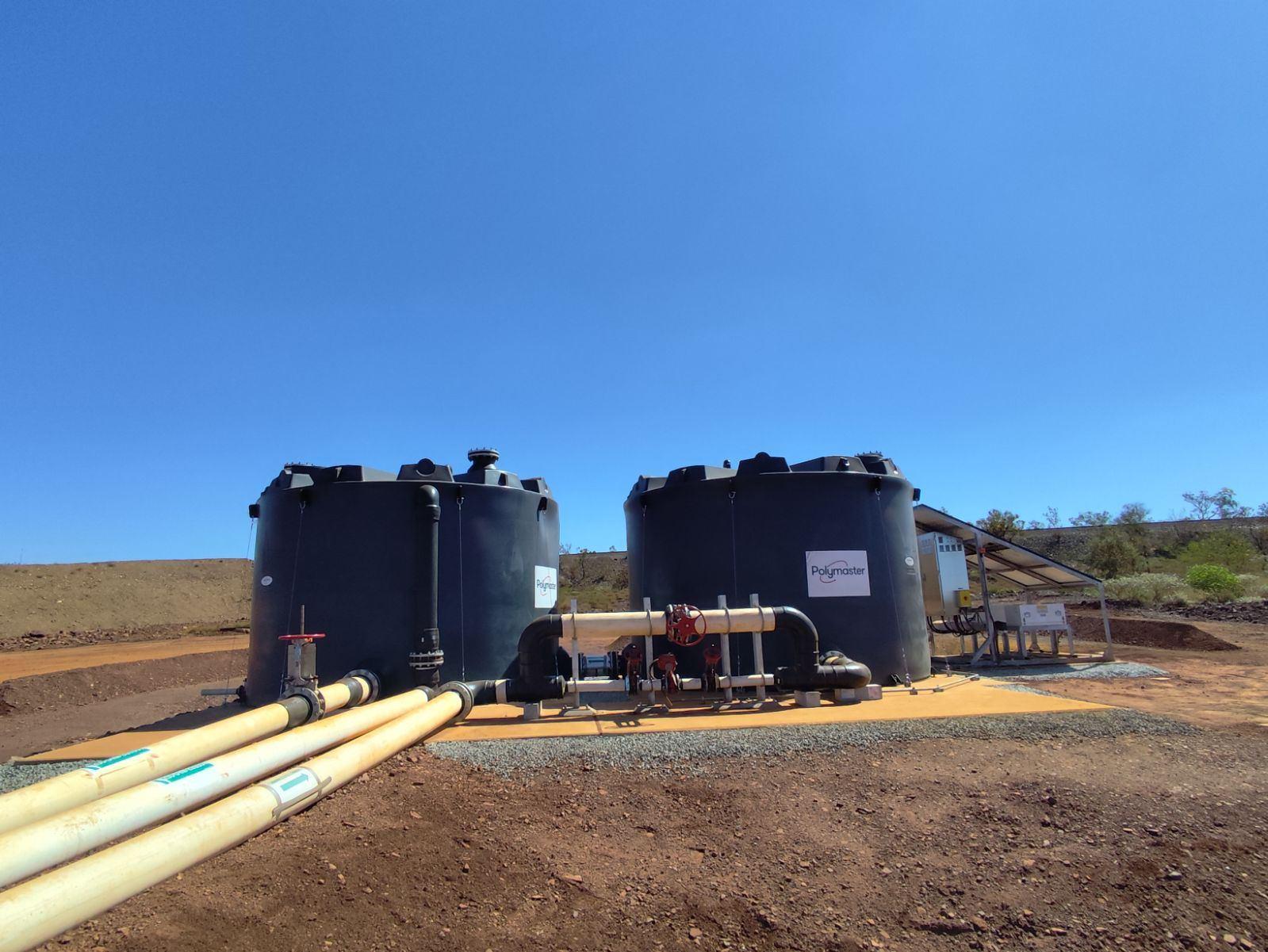

Tank installation

Scope of Work

Design, engineering, construction and commissioning of pipeline and associated equipment to supply raw water to the Managed Aquifer Recharge (MAR) area. Multi-discipline scope covering civil & earthworks, structural, mechanical, pipeline, electrical, control and communications — delivered across multiple mining tenements with welding within an active rail corridor.

Project Highlights

  • 39,000 manhours recordable-injury free
  • 9,900 m of HDPE pipe installed
  • Headworks and tank installation
  • Welding within an active rail corridor

Client
Project
Location
Date
Value

BHP
Jugari MAR
Jugari, WA
December 2023 — July 2024
$6.0M

Equipment Engaged +

Earthworks

  • 16t / 24t / 33t Excavators
  • Cat 950 Wheeled Loader
  • PosiTrack Skid Steer
  • 12t Pad Foot Compactor

Welding

  • Vietz VFT-500
  • Dixon HF225 / HF350

Site Fleet

  • 6×4 Tipper Truck
  • 4×4 Canter Crew Truck
  • 14,000 L Water Cart
  • 20t Franna Crane
  • Light Vehicles

Other

  • 30 kVa Generators
  • Hydrotesting Trailer
  • 10 × Water-Filled Barriers
Safety Performance +
AIFR
All Injury Frequency
0.00
LTIFR
Lost Time Injury Freq.
0.00
MTIFR
Medical Treatment Freq.
0.00
RWIFR
Restricted Work Freq.
0.00
TRIFR
Total Recordable Freq.
0.00

Case 06 · P25010

Christmas Creek TSF3

Flinders Tailings Pipeline

In progress

// HERO IMAGE
Tailings pipeline extension

Tailings pipeline extension

// OUD CHANNEL CROSSING

OUD channel crossing

// OVERLAND HDPE

Overland HDPE

Scope of Work

Christmas Creek OPF disposes tailings into a TSF approaching capacity in late 2025; Flinders TSF3 has been identified as the replacement. PPS is extending the existing tailings pipelines from OPF 1 and 2 to the new TSF — eight new pipe services in total, including the OUD Channel Crossing buried under concrete culverts, tie-ins and shutdown works.

Project Highlights

  • DN400 CL300 HDPE line steel spools & fittings
  • DN500 PN25 overland HDPE pipe & fittings
  • DN500 PN20 HDPE decant return line
  • OUD channel crossing — buried, weighed by concrete culverts
  • 8 new pipe services across tailings, decant & dewatering

Client
Project
Location
Date
Value

Fortescue
Christmas Creek TSF3 Tailings Pipeline
Christmas Creek, WA
April 2025 — March 2026
$13.7M

Equipment Engaged +

Earthworks

  • 37t Excavator
  • 45t Excavator
  • 2 × Wheel Loader
  • 2 × 15t Padfoot Roller
  • Trench Roller
  • 2 × Skid Steer

Welding

  • Vietz VFT-500 Welding Machine
  • McElroy T900 & T500 Tracstar
  • Dixon HF355 / HF630

Site Fleet

  • 6×4 Isuzu 15kL Water Cart
  • 2 × Volvo ADT-40
  • 6×4 Tipper
  • 5 × Dual Cab Utes
  • 22-Seat Bus
  • Franna Crane

Other

  • Site Crib & Office
  • Generators
Safety Performance +
AIFR
All Injury Frequency
0.00
LTIFR
Lost Time Injury Freq.
0.00
MTIFR
Medical Treatment Freq.
0.00
RWIFR
Restricted Work Freq.
0.00
TRIFR
Total Recordable Freq.
0.00

Case 07 · P23050

Carey TSF1 Wall Lift

Mechanical Scope · Tailings Delivery Replacement

Completed

// HERO IMAGE
TSF1 tailings pipeline replacement

TSF1 tailings pipeline replacement

// DN400 PIPE REPLACEMENT

DN400 pipe replacement

// DECANT RETURN INSTALL

Decant return install

Scope of Work

Removal of buried decommissioned HDPE pipeline sections, installation of new tailings delivery and gland water pipelines, and replacement of the DN400 tailings delivery pipeline from pump house to TSF3 — including sections through existing DN630 sleeves under Whaleback Creek and the LV access road. Scope covered concrete thrust blocks, anchor blocks, footings and slabs; disassembly and reinstatement of existing TSF1 distribution pipelines after wall raise; hydrostatic testing; ~530 m DN280 HDPE decant return from new pontoon to booster pump station; and ~950 m DN280 common decant return along the TSF1 crest back to the Beneficiation Plant.

Project Highlights

  • DN400 tailings delivery pipeline replaced pump-house to TSF3
  • ~530 m DN280 HDPE decant return installed
  • ~950 m DN280 common decant return along TSF1 crest
  • TSF3 decant system kept operational throughout works
  • Contingency planning across planned shutdown windows

Client
Project
Location
Date
Value

BHP
Carey TSF1 Wall Lift — Mechanical
Newman West Mine, WA
April 2023 — April 2024
$4.5M

Equipment Engaged +

Earthworks

  • 2 × 24t Excavator
  • 16t Wheeled Loader
  • Skid Steer
  • 700 kg Plate Compactor

Welding

  • 2 × McElroy T500
  • 2 × HD225 Dixon Welder
  • 15t Winch

Site Fleet

  • 20t Franna
  • Water Cart
  • Light Vehicles

Power

  • 6 kVa Gensets
  • 9 kVa Gensets
Safety Performance +
AIFR
All Injury Frequency
0.00
LTIFR
Lost Time Injury Freq.
0.00
MTIFR
Medical Treatment Freq.
0.00
RWIFR
Restricted Work Freq.
0.00
TRIFR
Total Recordable Freq.
0.00
